Both the Library >Job Properties > Security and Job Properties > Security forms let you to define two different levels of security. These two levels of security can be used together or independently on a job-by-job basis.
After the server has been set up for network job security, you are ready to define which users on your network will have access to a specified job on the Job Properties > Security page for the job.
The data in the Master Job Properties form is automatically copied to any newly created jobs. If all of the jobs that you create in Estimate will use the same data, descriptive information and rules, defining the data in the Master Job Properties form will save time when you create new job folders in Estimate.
From the Backstage View, select Library from the left pane navigation.
Select the Setup tab.
Select Job Properties.

On the Job Properties form, select the Security tab.

Select the Restrict access to this job to the following users check box.
Click Add Users/Groups, and select the preferred users and groups from Windows Active Directory.
Click OK.
From the Backstage View, select Library from the left pane navigation.
Select the Setup tab.
Select Job Properties.
On the Job Properties form, select the Security tab.
In the Users allowed in this job pane, select the users and groups you want to remove access to this job.
Click Remove Selected Users/Groups. Then click OK.
The Estimate Protection data box locks down specific data fields to protect them against unauthorized (or inadvertent) change. You can protect an unlimited number of data fields in your estimate. After protected, only authorized users (those that have the password) are able to edit those fields. Protected fields display in one of two ways, represented by a background color in the field:
Protected (pale blue) - Locked to prevent changes.
Protected Unlocked (pale yellow) - Fields that have been defined as protected but can be edited by authorized users only after they enter a password.
The colors described above are the system default for these fields.
User Access lets you establish which users on your network have access to the current job.
Allow ALL users with Bid Wizard access to use this job as a source - Clear this check box to prevent unauthorized users from copying the contents of the job through the Bid Wizard.
Before you can lock individual form fields in the current job, you must first enable field level security and also create a password that users must enter to modify protected data fields.
The data in the Master Job Properties form is automatically copied to any new job you create. If the jobs you create all use the same data, descriptive information and rules, define the data in the Master Job Properties form to save time whenever you create new job folders.
From the Backstage View, select Library from the left pane navigation.
Select the Setup tab.
Select Job Properties.
On the Job Properties form, select the Security tab.

Select the Enable field level estimate protection check box.
Type a password into the Password field. Passwords are case-sensitive and must be at least six characters long.
If you lose or forget a password, it cannot be recovered. It is recommended that you keep a list of passwords and corresponding jobs in a secure location for you to refer to if needed.
In the Confirm Password dialog box, type the password again. Then click OK.
Estimate can grant permissions at a deep-rooted level by assigning which roles can access specific forms. You can also assign certain roles that can perform specific commands or actions that can be performed within those forms.
Permissions are managed in the Access Control Register in the Setup tab of the Library.
This register is a list of accessible objects, which can be used to grant or restrict permissions to various roles. By default, the register is organized by type, then by category. Removing the grouping lets you search for key words using the search capabilities of the register.

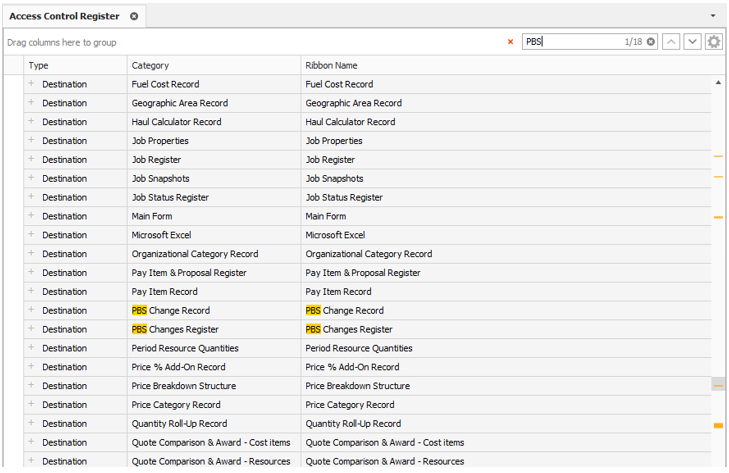

The Type of the accessible object is one of the following:
• Command: Actions that are in the main ribbon navigation.
• Destination: A form or location within the application. Restricting this type of permission means that all the actions that are available in the form are unavailable.
• Register Command: These are the commands that appear for the specified register and are commonly accessed either by using the actions menu in the navigation ribbon when the register is active or using the right-click context menu commands on the records in a register.
Categories and subcategories can be used to further group and identify various accessible objects.
The Ribbon Name column provides the navigation path and name of the object as it appears in the ribbon navigation. The Show Classic Navigation Accessible Objects button on the Actions tab of the Access Control register can be used to identify accessible objects as they might have existed in the legacy version of Estimate, and are still available to assist users who may have set up Access Control prior to the newer ribbon navigation.

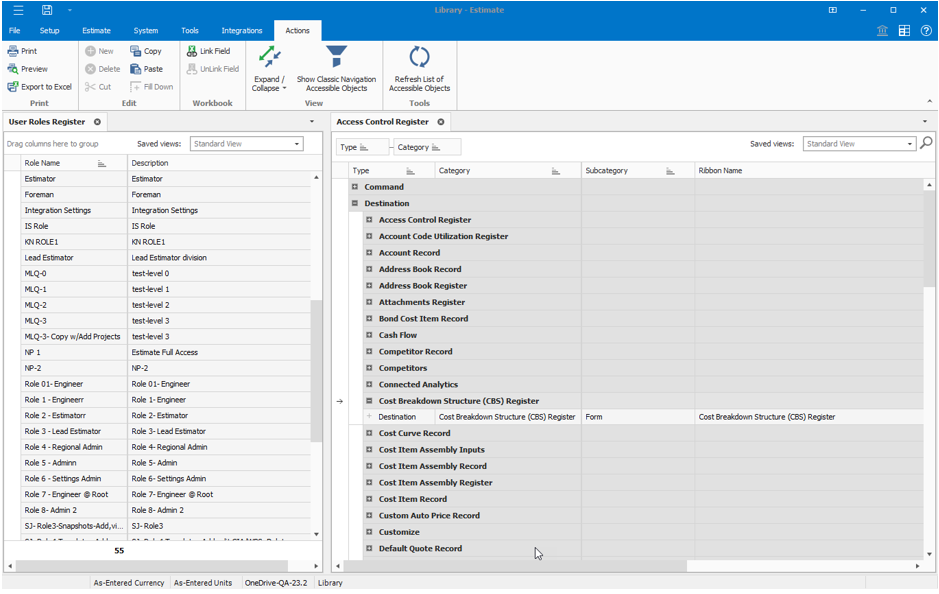

Follow these steps to set up Access Control on an Accessible object:

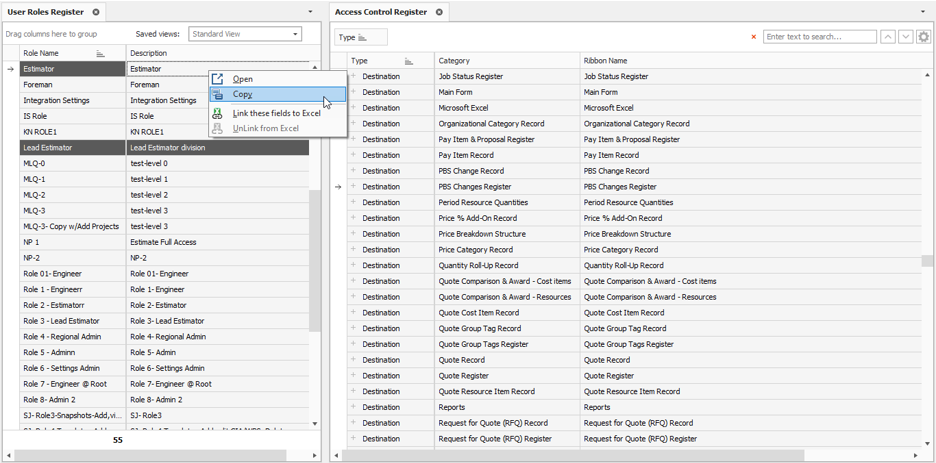

Identify the role or roles in the User Roles register, then right-click to copy.

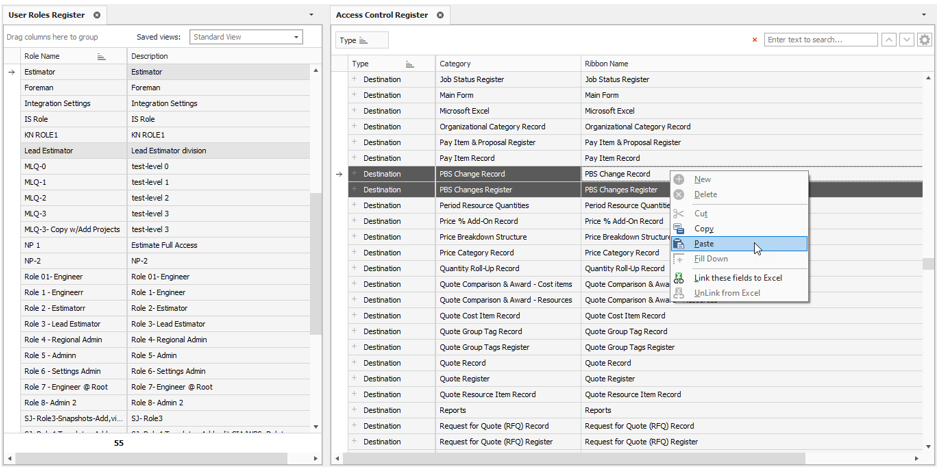

Select one or more accessible objects in the Access Control register and right-click to paste.

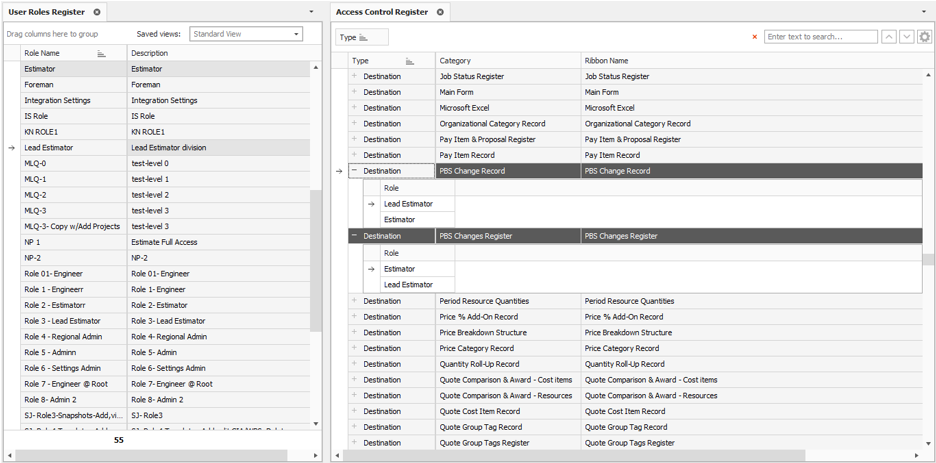

Expand the detail records of the accessible objects to verify the role assignments have been correctly made.
You can drag and drop the Roles onto the accessible objects in these two registers.
If no roles are assigned to an accessible object, no restrictions are applied to the accessible object, and anyone with access to the application will be able to access that destination or command. When setting up Access Control, be sure to identify the commands and destinations in Estimate that you want to restrict permissions to, and then assign the roles to explicitly grant permissions to those accessible objects

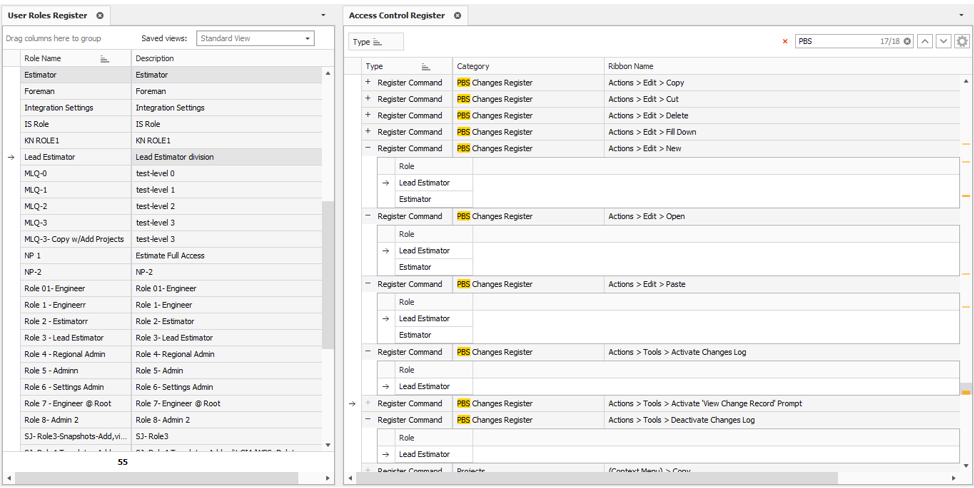

In the following example, both Estimators and Lead Estimators are permitted to invoke any of the actions on the records in the PBS Changes Register, but only the Lead Estimator is permitted to activate or deactivate the PBS Changes Log. Because no roles have been assigned to the Activate ‘View Change Record’ prompt, anyone with access to the application will be able to perform that action.
The process of creating an estimate for a bidding opportunity commonly requires unrestricted access to the capabilities of Estimate so that estimators can work efficiently. However, depending on the level of data governance within an organization, you might want to preclude certain users from accessing some of the more sensitive parts of Estimate. If changes were made, either accidentally or otherwise, it could impose detrimental impacts on the organization.
Estimate’s security model is very detailed and robust. When designing a security model that restricts certain features and functionality of Estimate, each company must weigh the benefit of the protection of such restrictions which could bring unwanted or uncontrolled changes and negatively impact the productivity of the estimating process. While it is possible to create a very detailed and robust security model with many different roles for individuals within an organization, it is not necessary to set up and maintain roles for all of Estimates accessible objects. It is likely a company can effectively secure their sensitive data with no more than a couple roles granting permissions to a few commands and destinations.
A common way to implement security on the Estimate application is to restrict access to certain system level settings, such as who can modify data in the library, or who can change any company specified custom column captions.
The following are some of the more common Roles a company may set up, describing the purpose of the role and typical permissions:
Lead Estimator: Lead Estimators are commonly assigned to estimates based on their knowledge and experience. They may be precluded from creating or deleting estimates themselves or changing any system level settings, but commonly have full access to all the capabilities needed to create and maintain the estimates they are assigned to.
Estimate Manager: Estimate Managers are commonly responsible for identifying bidding opportunities and determining which opportunities to pursue. Once it has been determined that the company will pursue an opportunity, the Estimate Manager creates the estimate and assign it to a Lead Estimator based on resource availability relative to all the bidding opportunities the company will be pursuing. These roles manage the creation of estimates and assist in ensuring all the necessary supporting data is available, such as assigning appropriate project attributes or including needed resource libraries.
Administrator: Administrators ensure accessibility and availability of the solutions utilized by estimators. Typically, they control system level settings and activities that would affect company standards, such as changing column captions, ability to define corporate views, list of job statuses and ribbon settings. Other typical permissions restricted to only the Administrator level roles are the ability to access the User Roles register and the Access Control register.
Additional Information
