Subtotals

The subtotal feature is for situations where the Owner wanted subtotals on the proposal form of pay item groups.

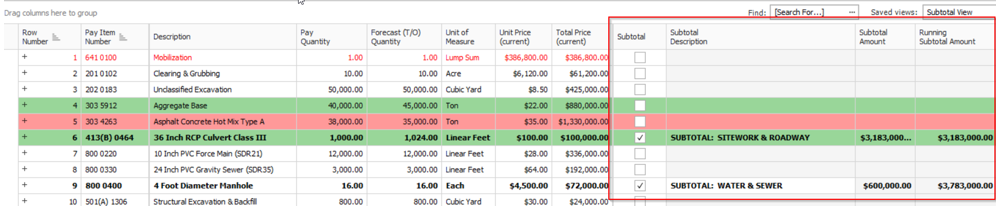

The following screen shot is using the supplied Subtotal register view:

From the Subtotal column, the last item in the subtotal group is where the box is checked. Once the box is checked, then a description may be entered. After the box is checked, the Subtotal Amount and Running Subtotal Amounts are then displayed in a bold font.

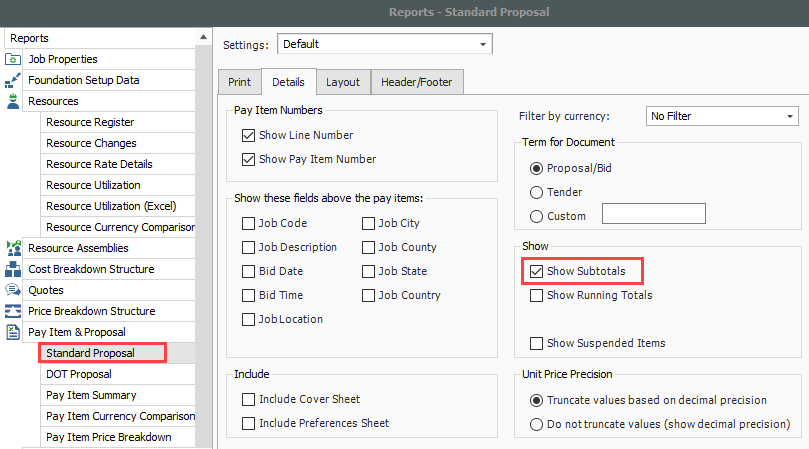

In our standard Proposal Report, there is an option to printout the subtotals.

Earnings Rules:

The Earnings Rules let you decide how much can be paid where certain work is completed. The cost items assigned to the pay items are where you can decide when to ask for payment.

The application is used in the Job Tracking form. The Earnings Rules also determine how the Cash Flow curve is generated.

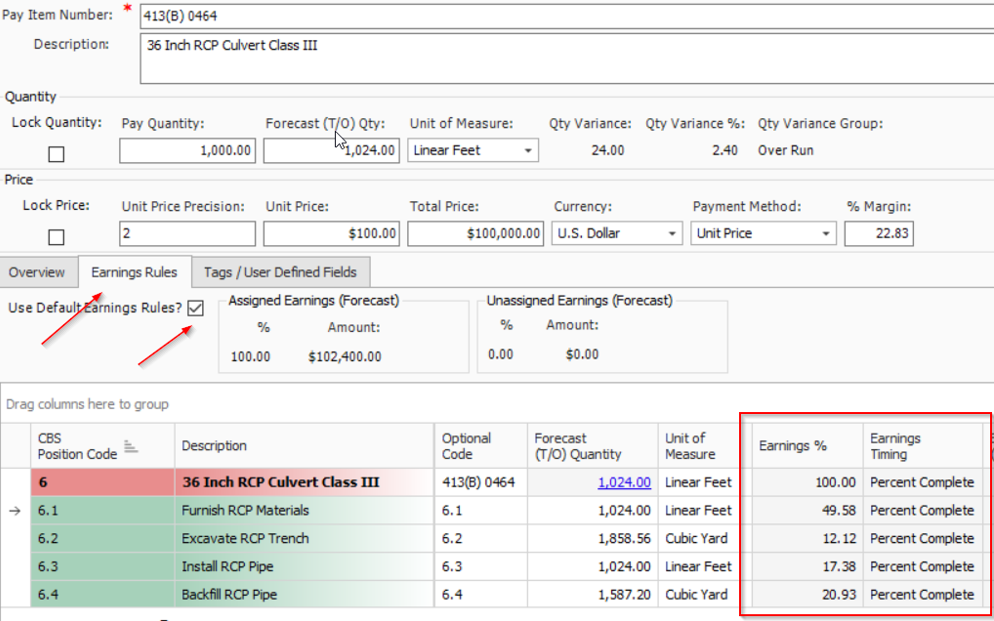

In the following screen shot, the record for 36 inch RCP Culvert Class III from the Training Job is open.

By default, the cost items in the Earnings % column are calculated based on the cost distribution. In this case where all the Materials are furnished and completed the Excavation, you have earned $49.58 and $12.12 for a total of 61.7% revenue.

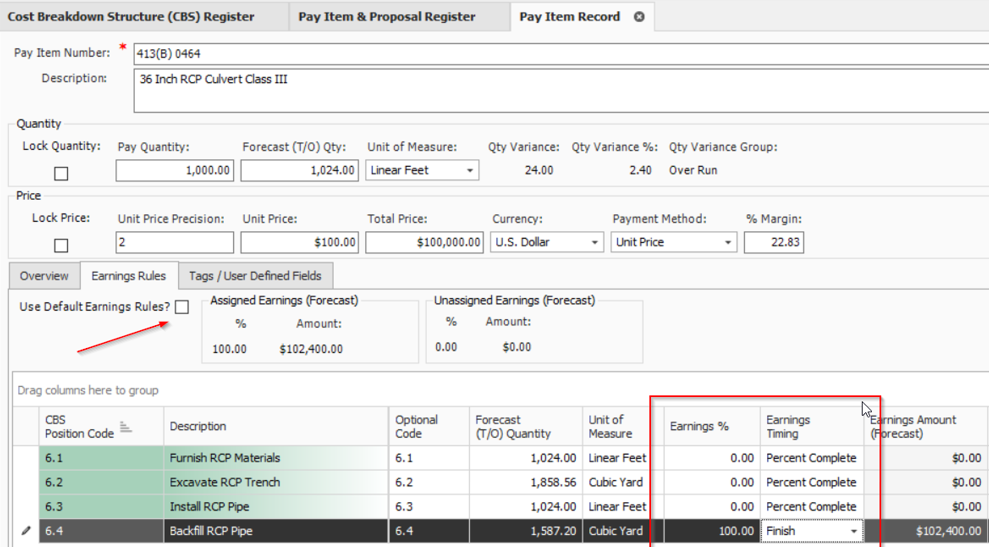

There may be times when you can only receive revenue when you have only completed the Backfill of the Pipe. In that case I can uncheck the Use Default Earnings Rules box, as seen in the previous screen shot, and enter 100%. You can then decide when to account for the revenue by changing the Earnings Timing.

The following screen shot show this option.

Another example is when you can get full payment for material on hand, such as Precast Girders. Then you can choose the start for the Earnings Timing. This way, the Cash Flow shows costs and revenue occurring at the start of the item.
