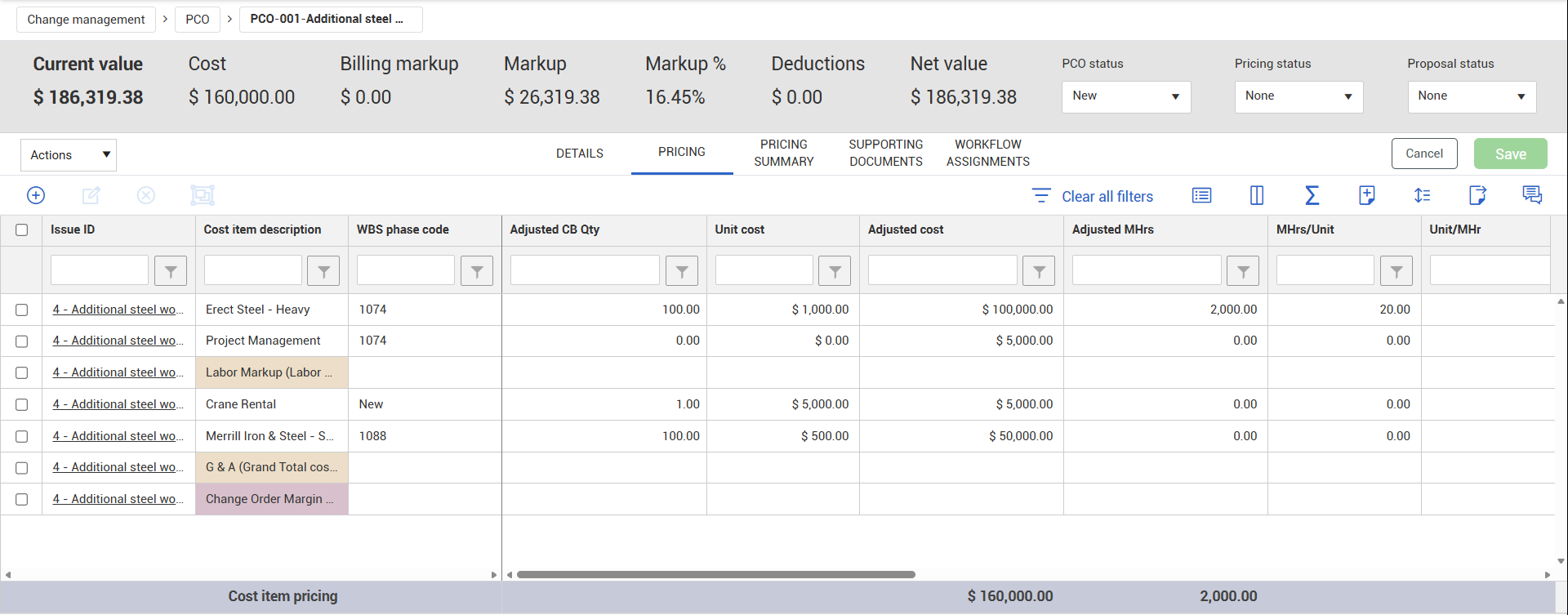

The PCO Pricing tab continues the pricing management that began on the PCO’s assigned issues. Therefore, when you first open the Pricing tab for a new PCO, you find it has inherited its issues’ subtotal values, along with Associated Vendors and their referenced contract. This automatic inheritance of issue values only occurs upon creation of the PCO.
As you assess the work related to the PCO and negotiate the potential change order, you can continue updating the pricing on the PCO, working towards an agreed upon change order price. When updating pricing, consider the following:
The Pricing summary value types follow the same precedence order as they did on issues, with the farthest-right value taking precedence:
The PCO’s Current Value is the sum of the Self perform, Vendor, and Time related overhead subtotals
If Change is not configured to automatically update value changes to higher levels, you can manually update the PCO Pricing tab with new pricing and associated vendor data from your issues. Select Update values > Pull values from issue from the Actions menu.
For example, you have a PCO with a total price of $10,210, totaled from Estimate values in the Pricing summary on the PCO’s Pricing tab.
As your field engineer assesses things out in the field, he determines the estimate to be a little low, so he changes one of the assigned issue’s Estimated subtotal to $12,000. You can update the PCO with the new pricing by selecting Pull values from issue from the Actions menu.
You will receive a prompt asking if you are sure you want to update the PCO’s values. When you select Yes, the PCO’s Estimate values update and the PCO’s new Grand total updates to $12,000.
Pricing changes made on the PCO do not change the pricing of the assigned issue(s).
Pricing changes made on the issues can only change pricing on the related PCO if you select Update PCO values with issue values from the Actions menu or you have configured Change to automatically update value changes to higher levels. Other, issue pricing on the PCO is only for informative purposes.
The ability to automatically update values from higher or lower levels is configured in project Settings > Configurations > Pricing configuration. When set to automatically update value changes to higher levels or lower levels, any changes made at the issue level are automatically reflected in the PCO. Any changes made at the PCO level are automatically reflected in the issue and CCO.
When the Change is not configured to update values to higher levels, you can manually update values as follows:
At the issue level, you can push values to the PCO. If the PCO is associated to a CCO, the value is automatically pushed to the CCO.
At the PCO level, you can push values up to a CCO or pull values down to an issue.
At the CCO level, you can pull values from the PCO. If the issue is associated with a PCO, the value is automatically pulled from the issue.
When Change is not configured to update values to lower levels, you can manually update values as follows:
At the issue level, you can pull values from the PCO. If the PCO is associated to a CCO, the value is automatically pulled from the CCO.
At the PCO level, you can push values to the issue or pull values from the CCO.
At the CCO level, you can push values to the PCO. If the issue is associated with a PCO, the value is automatically pushed to the issue.
If you make a change to the pricing at any level, the Pricing pages at the other levels show a banner warning that the updated values are not reflected at all levels. For example, if a pricing change is made at the issue level, the banner shows at the PCO and CCO levels. To update values, go to the Actions menu. Then select whether to push values down or pull values up.
