Explore 26.10 Release Notes

This is a preview of the upcoming release. General release is available starting 09-NOV-2026.

APIs

  • (Breaking change) SelfService_Control_CostItemDetail – Due to outdated naming conventions, this API has been deprecated and all fields report null values. This API will be removed in a later release. The SelfService_Control_CostItemUserDefinedTag and Explore_Control_CostItemAttribute APIs should be used instead.

  • (Breaking change) SelfService_Estimate_QuantityItemSource – The fields IsDelta and IsMissing in this API only report null values in this release.

  • (Breaking change) Estimate APIs deprecated – These APIs were deprecated in Release 26.5 and have now been removed from the APIM Developers Portal: SelfService_Estimate_AccountsCalculatedValue, SelfService_Estimate_AccountsReferencedData, and SelfService_Estimate_QuoteResourceItems.

  • InEight Contract new API – The new API SelfService_Contract_ContractTerm has been added for Contract.

  • InEight Control new API – The new API SelfService_Control_IntegrationAuditLogDetail has been added for Control.

  • InEight Estimate new API – The new API SelfService_Estimate_CBSRegister has been added for Estimate.

  • SelfService_Core_Project – The new field IsProjectAccessRevoked has been added to this API.

  • SelfService_Design_ScopeItemClaimingStepDetail – The new field PlannedMHrs has been added to this API.

  • SelfService_Design_ScopeItemQuantityClaim – The new fields ActualFinish, ActualStart, and EarnedMHrs have been added to this API.

  • SelfService_Plan_WeeklyTimesheetVersion – The new field TimesheetCreatedDate has been added to this API.

Application

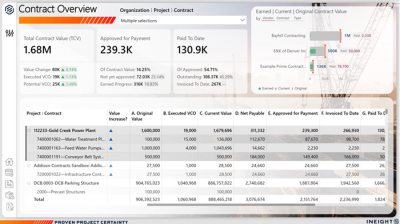

  • InEight Contract Portfolio dashboard – The new Contract Portfolio Dashboard provides a consolidated view of contract performance across the full commercial lifecycle, helping teams understand how contract value progresses from committed scope through payments, invoices, deliverables, and vendor change orders. ClosedRead more

    This dashboard allows project, commercial, and finance teams to quickly assess:

    • Overall contract value and commercial position

    • Payform status, net payable, paid-to-date, and outstanding amounts

    • Invoice trends, invoice aging, payment timing, and open payable position

    • Deliverable and line-item progress, including invoice received and goods received status

    • Vendor change order exposure, execution status, and commercial impact

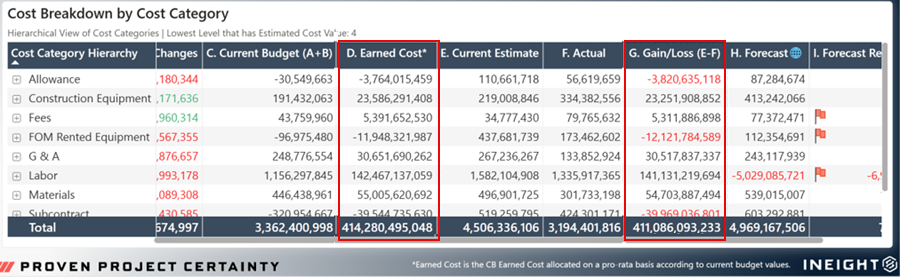

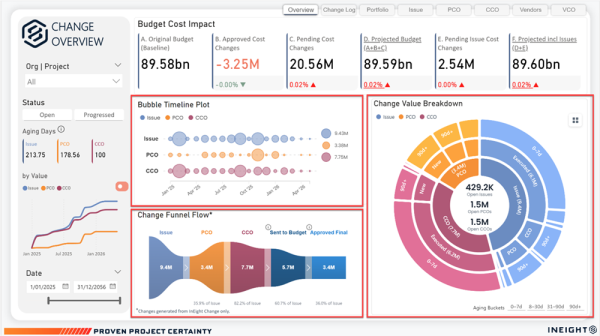

  • Project Controls dashboard Forecast Earned Value (Forecast EV) Curve – A new Forecast Earned Value (Forecast EV) measure has been added to the Project Controls dashboard data model. ClosedRead more

    Forecast EV represents the projected value expected to be earned over the remaining duration of a project and can be used alongside existing cost and earned value metrics to provide additional insight into forecasted project performance. The measure is calculated using the following formula:

    Forecast EV = (Forecast Remaining Quantity ÷ Total Quantity) × Forecast Total Cost

    Where:

    • Forecast Remaining Quantity = Quantity remaining to be completed.

    • Total Quantity = Actual Quantity to Date + Forecast Remaining Quantity.

    • Forecast Total Cost = Actual Cost to Date + Forecast Remaining Cost.

    This calculation distributes the total project cost based on the proportion of remaining work in each forecast period, producing a forecast earned value curve that can be compared against Forecast Remaining Cost to assess the alignment between projected value delivery and planned expenditure.

    The Forecast EV measure is available within the dashboard's underlying data model and can be accessed when editing the dashboard to create custom visualizations, including a Forecast EV curve.
