This workflow shows the two modules of InEight Plan, Work Packaging and Quantity Tracking, and how these modules connect to the InEight Suite to track quantities and hours.InEight Plan & Progress General Workflow
This graphic outlines how components and claiming schemes in InEight Plan relate to organizational structures in InEight Control and InEight Contract.Quantity Tracking Relationships

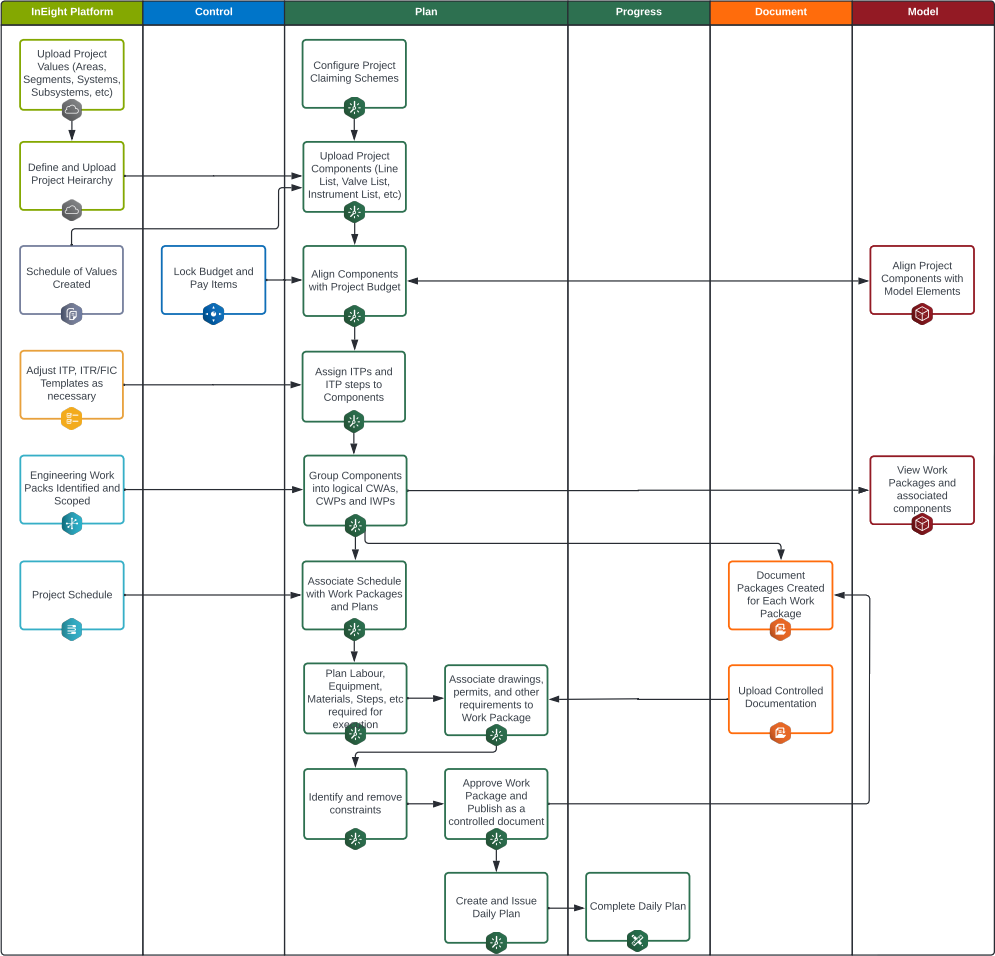

This workflow shows how work packages are detailed out and prepared for execution in Plan Work Packaging, and the available integrations for work packages.Work Planning and Packaging Workflow

This workflow shows integrations between the Work Packaging module and other InEight products.Work Packaging Integrations

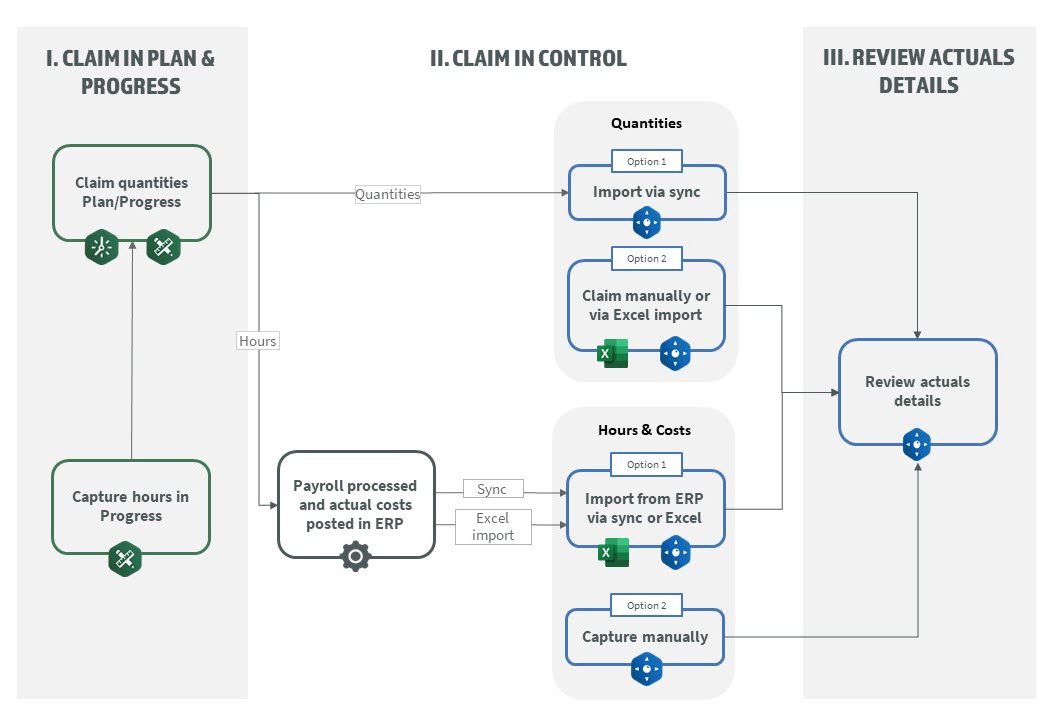

This workflow shows how actuals are processed through InEight Plan, Progress, and Control. Actuals Workflow
Additional Information
