Project Resources

The Resource Management function provides schedulers with the ability to account for and report on the project resources (for example, labor, materials, or equipment) that are needed to plan the scheduled work.

From a shared organization resource pool, schedulers can assign the required resources to activities. With the resource utilization data, InEight Schedule can assess cost and time impacts in a time-phased manner.

Step by Step — Import resources from Knowledge Base Resource register into Project Resources Register

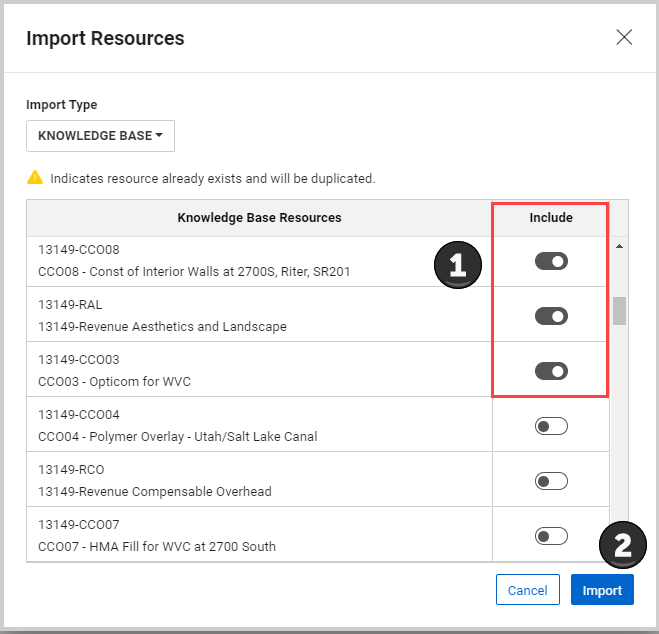

  1. Click on the Import Resources icon, and then select Knowledge Base from the Import Type drop-down menu.

  1. Select the Knowledge Base resources that you want to include in your project, and then click Import.

    The symbol indicates that the resource already exists and will be duplicated.

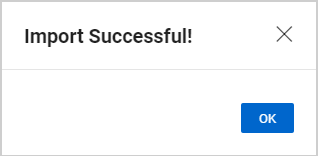

  2. You will see an Import Successful message. Select OK.

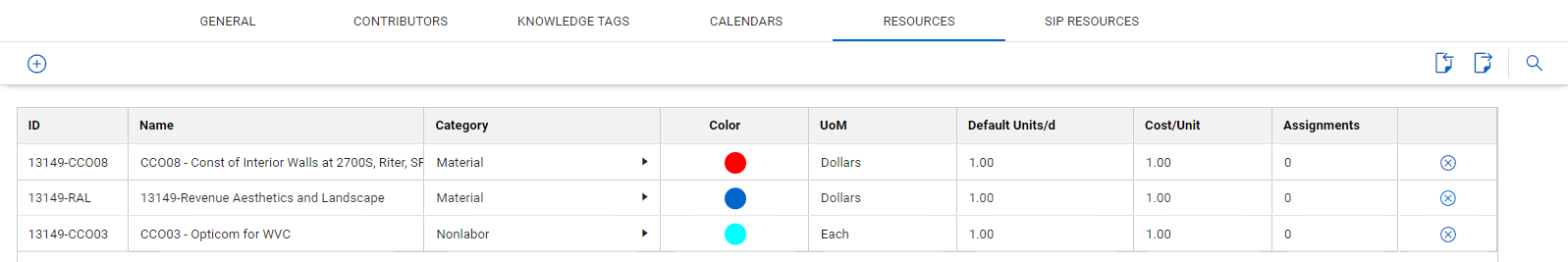

    The selected resources are now imported into the project from the Knowledge Base Resource register.

Resource Assignments

Resources are assigned to activities (activity level) but can also be set via work packages (summary level) in the schedule.

Step by Step — Assign Resources at the Activity Level

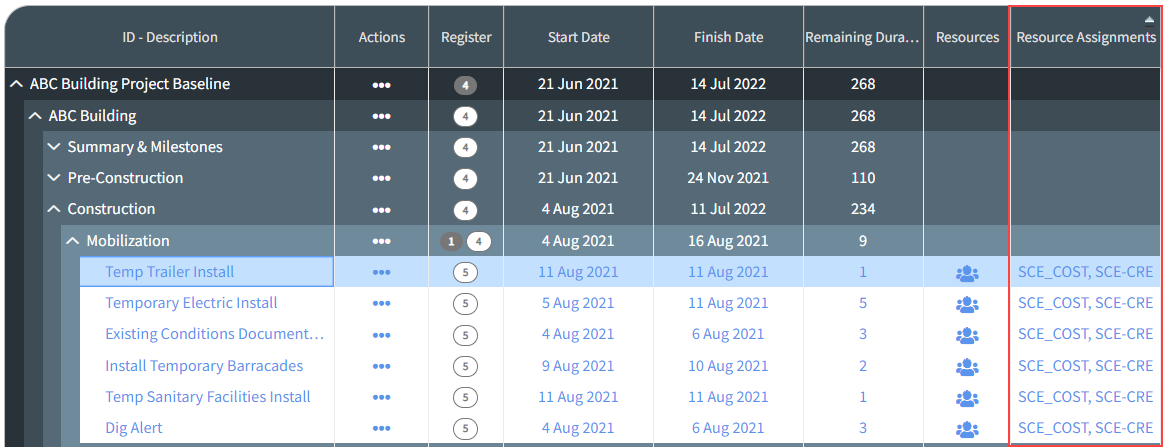

From the plan view, access the resource assignments of the assigned by using the options below:

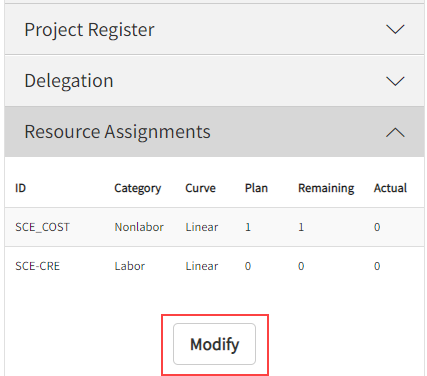

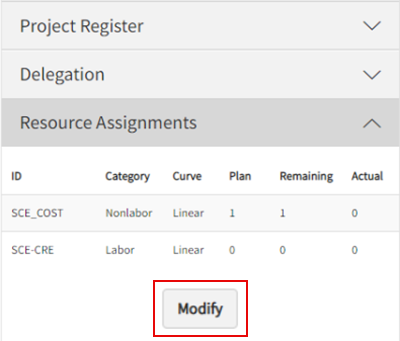

  • You can open an Activity’s details in the Iris, expanding the Resource Assignments section, and selecting Modify.

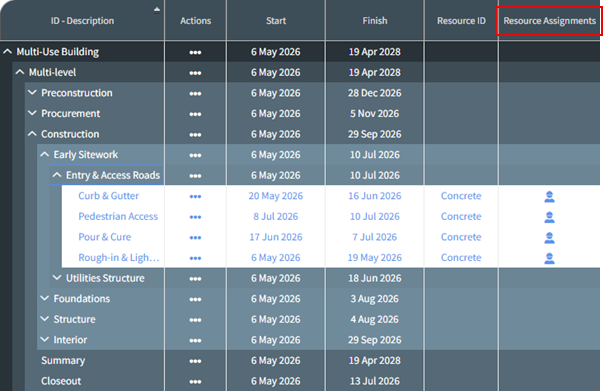

  • You can customize the Gantt Chart view to include the Resources Column and selecting the Resources icon directly in the Gantt Chart.

    • When either of these options have been selected, the resource assignment window appears:

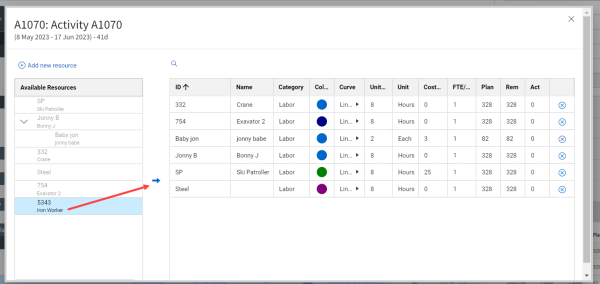

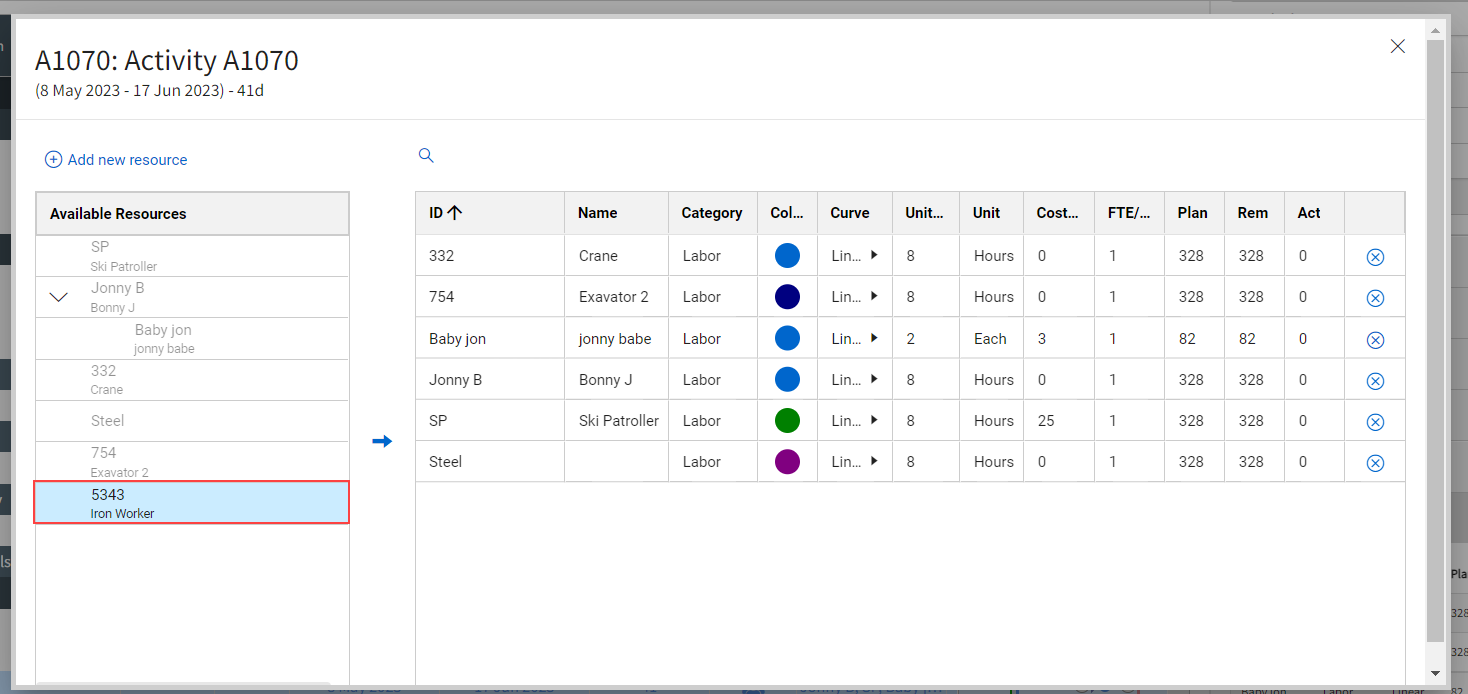

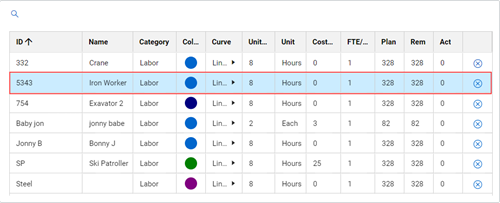

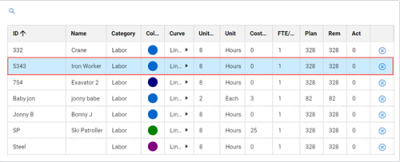

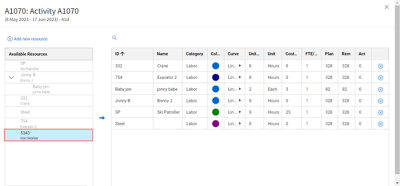

  1. In the resource window, under Available Resources, select the resource.

    All available resources can be quickly found using the search function in the resource assignment window. If a resource cannot be found or a project-specific resource is to be made, see “Creating Project Resources via Resource Assignment” on for more information.

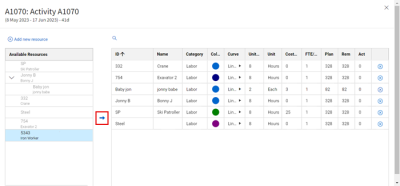

  2. Once selected, click the right arrow to add the resource to the activity’s Resource register.

    Double clicking a resource will also add it to the activity’s Resource register.

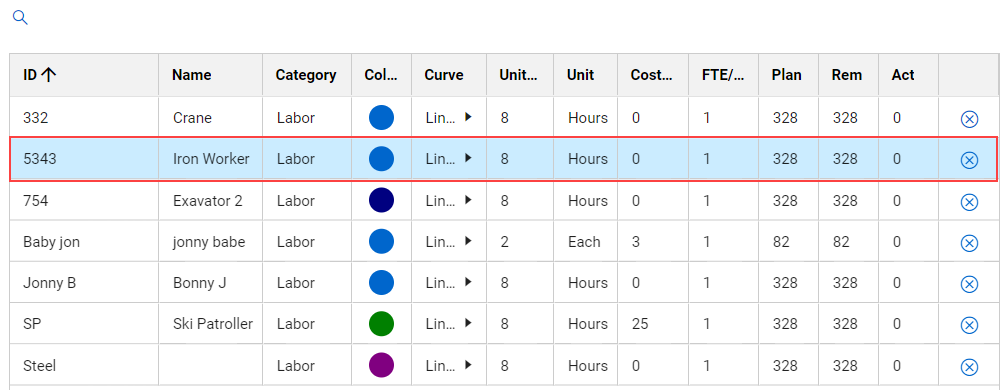

  3. Once added, details for each resource can be modified for the activity. Fields that can be adjusted at this level include Curve, Units/d, Cost/Unit, FTE/Qty, and Plan.

    If a resource is not available in the Project’s resource register, a new resource can be created directly from the Resource Assignment window. See "Creating Project Resources via Resource Assignment" topic.

Fill Down

The Fill Down function lets you fill down a calendar, code or resource from the summary level. You select the items to fill down, the system fills down the selections and processes the items to all child level elements.

Step by Step — Fill Down from the summary level

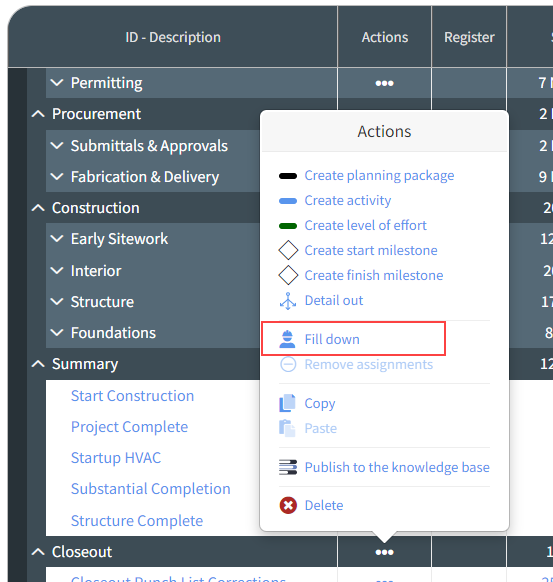

  1. Identify the summary level planning package to assign resources to, and select the Actions icon.

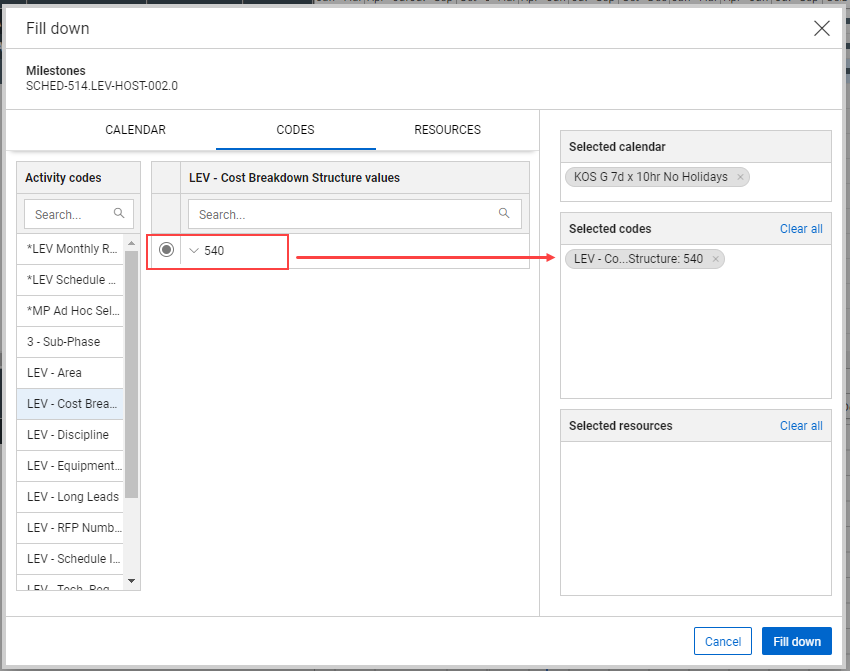

  2. In the Actions menu, select Fill Down.

    • The Fill down window appears

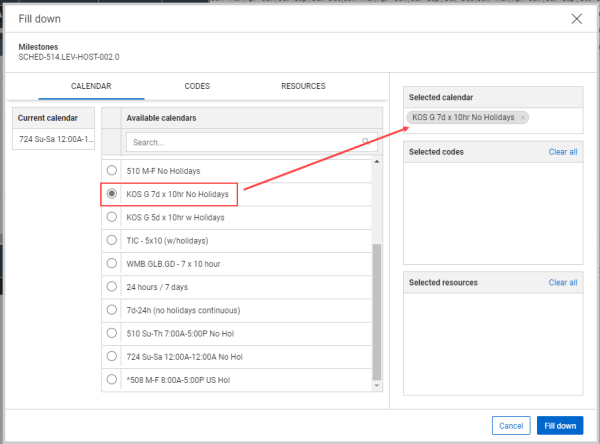

  3. Under Calendar, choose a calendar from available calendars

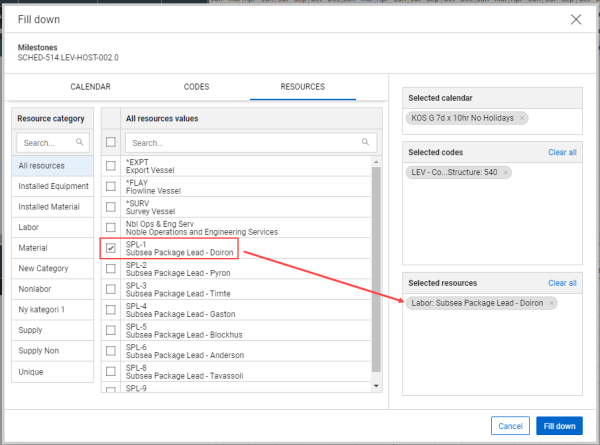

  4. Click on the Codes and select any Activity Code.

  5. Click on Resources and select any Resource value.

  • All assignments made from this window flow down to all subordinate activities.

All available resources can be quickly found using the search function in the resource assignment window. If a resource cannot be found or a project specific resource is to be made, see the “Creating Project Resources via Resource Assignment” section for more information.

Resources can still be further edited at the activity level even when set up from the summary level. Plan values are not editable when applying a resource at the summary level but can be adjusted act the activity level.

Resource Histogram

After a schedule has been loaded with resources, Schedule can generate a resource histogram.

Step by Step — Generate a Resource Histogram

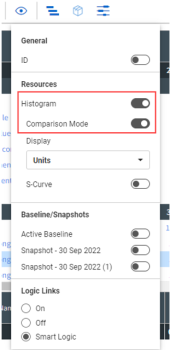

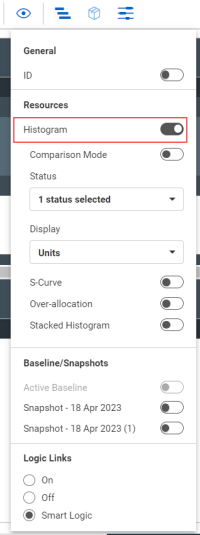

  1. In the Schedule’s Planning View, select View Options.
    • A drop-down menu appears where you can switch the Resource Histogram on or off.

  2. Switch the histogram from off to ON.

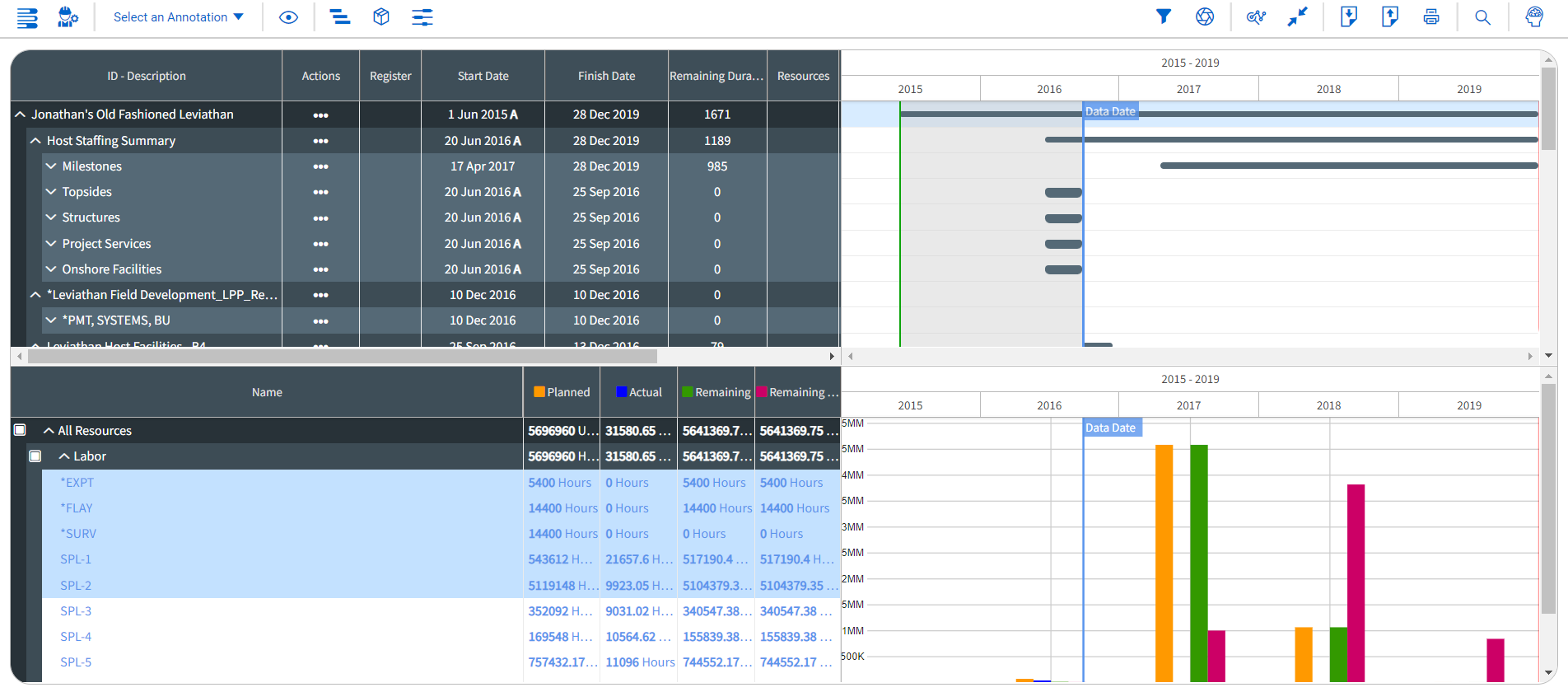

  3. A histogram shows below the Gantt Chart. The resource histogram plots resource utilization over time depending on the following:

    • Resource Settings Configuration Options: When the resource histogram is switched on, more settings become available for configuration.
    • Setting

      Function

      Resource Histogram

      You can switch the Resource Histogram view on or off.

      Comparison Mode Compares Current, Active Baseline, and Snapshots in the Resource Histogram.

      Status

      Filters histogram to show Planned, Actual resource quantities, Remaining or Remaining Late.

      Display

      Adjusts the Y-axis of the histogram to show Units, FTE, or Cost.

      Unit

      The resource’s unit of measure.

      S-Curve

      Switches on or off the S-Curve on the resource histogram.

    • The activity or summary level selected in the Gantt Chart: The resource histogram plots out data based on the activity or planning package selected in the schedule

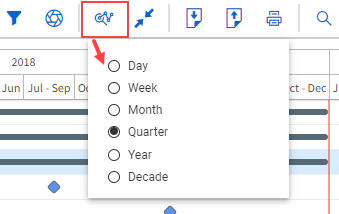

      • The zoom level selection: The zoom level for the Gantt chart controls both the schedule and resource histogram X-axis units of time that is days, weeks, months, quarters, years or decades.

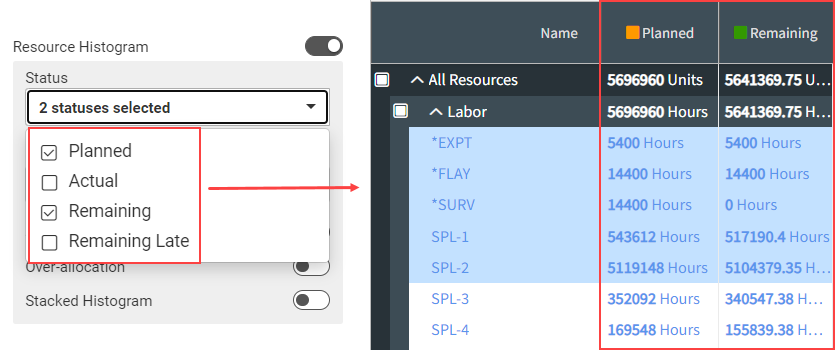

  4. Set the Resource Setting Configuration Status to Planned & Remaining.

    This populates the Resource Histogram with all planned and remaining resources for the activity or planning package selected.

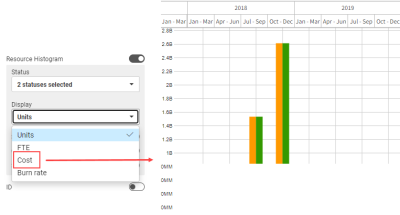

  5. Change the Resource Setting Configuration Display from Units to Cost.

    • FTE stands for Full Time Equivalent, and is the count of people per time period.

    • Burn rate is the percent planned per period of time.

    • This adjusts the Y-axis values from resource quantities to dollars

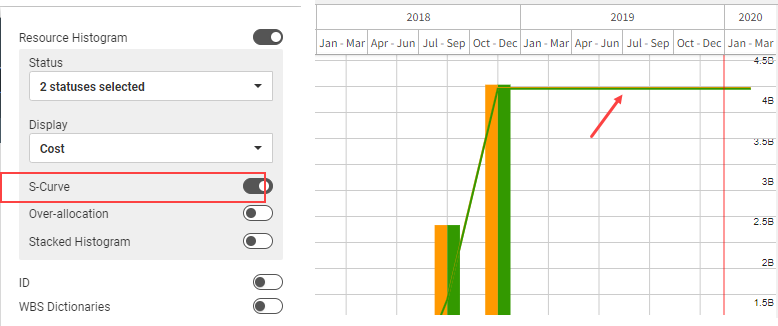

  6. Switch on the S-Curve. This overlays the S-Curve on the Resource Histogram.

S-Curves reflect cumulative data. As the values increase over time, this reflects the accumulation of resource units/FTE/cost, depending on settings, over time.

Filtering by Resource

Filtering by resource only applies if the stacked resource histogram is turned to On.In the filter functionality, the Gantt chart & resource histogram can be filtered to see planning packages and activities assigned specific resources. When the resource histogram is switched on, it can be used as an interactive filter as well. Selecting a Resource Name listed in the histogram or any of the resource bars will filter down the Gantt Chart and Resource Histogram to show only data pertaining to the information selected.

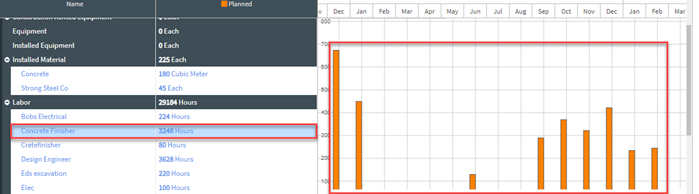

In the image below, the Resource Histogram is filtering based on the selected resource: Concrete Finisher.

Additionally, to modify or disable the resource filtering, users may click the filter icon to make adjustments to the filter parameters.

Histogram Comparison Mode

In View Options, you can view the histogram in comparison mode, when enabled.

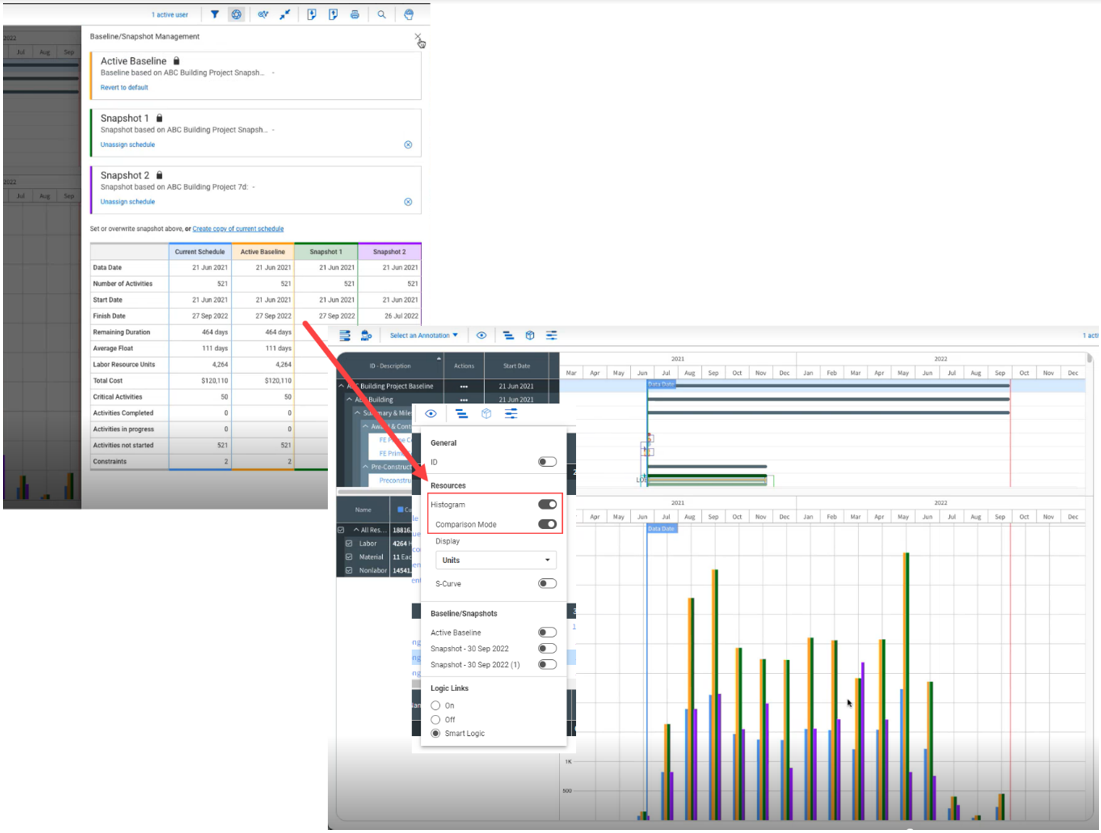

When the Comparison mode toggle is set to On, the baselines and snapshots that exist in the Baseline/Snapshot Management show as a graph with the current baseline. The histogram compares resources rolled up to the category type and shows you resources as they trend.

Each line in the graph represents a baseline, snapshot, and the current estimate.

The histogram graph can now also be shown in units and burn rate.

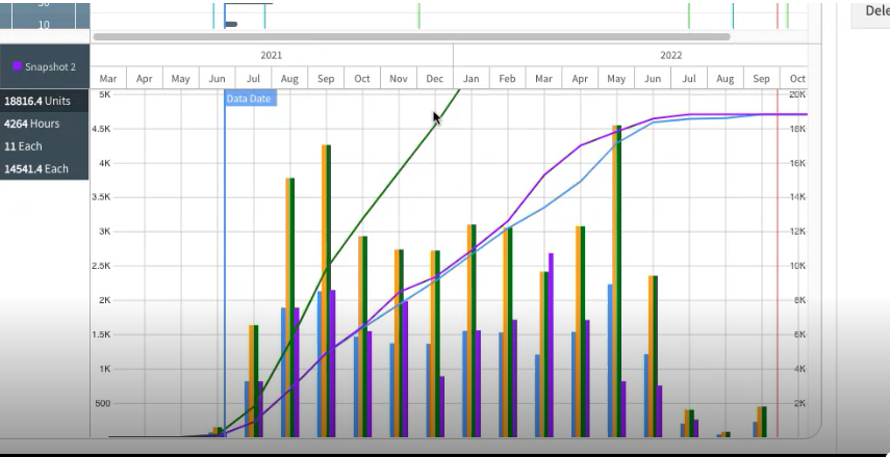

You can also view the histogram with an S-Curve that shows you a cumulative trend line for each baseline, snapshot and current.

Export Assignments

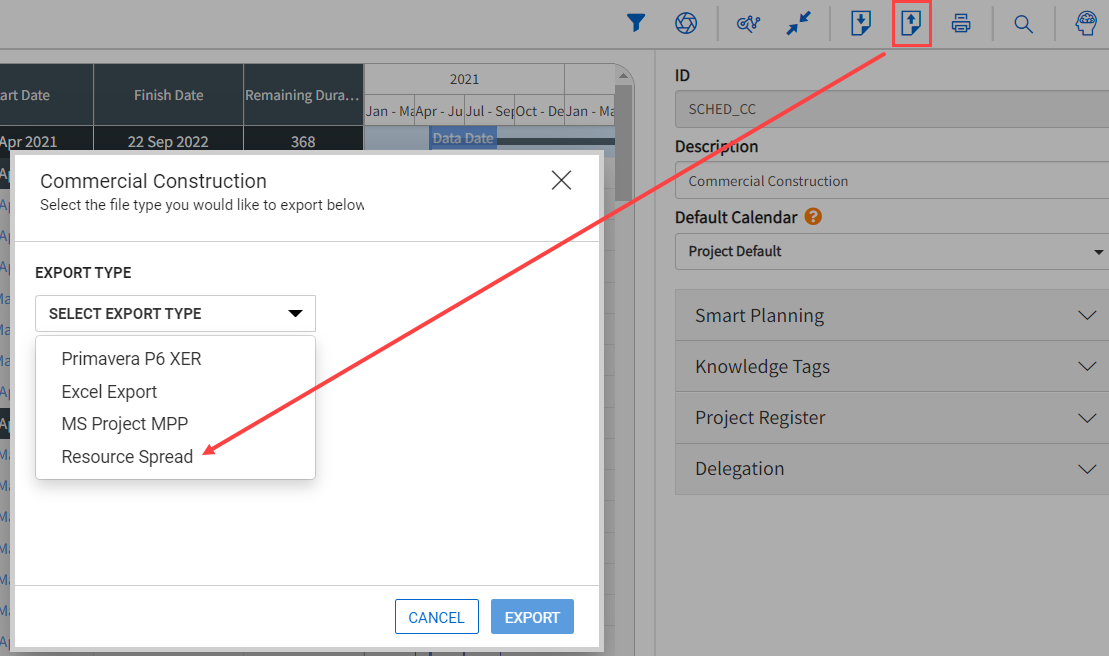

Schedule export functionality includes the ability to export resource assignments. Select the Export icon, then select the Resource Spread export type from the drop-down menu.

Project Specific Resources: Project Configuration Setup

Resources in a Project are either global resources or project specific resources. Global resources automatically populate a project’s resource register from the Knowledge Base. If a resource is not available from the established global resources, project specific resources can be set up.

Project specific resources are useful when the resource utilized is unique to that project and not applicable across the organization.

To establish project specific resources:

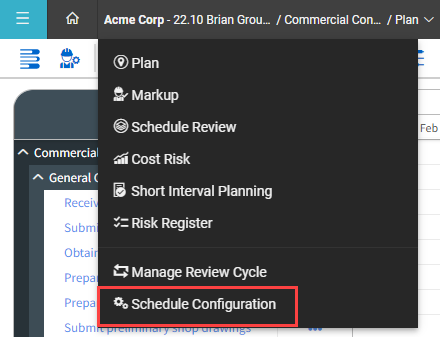

  1. Select Schedule Configuration from the project drop-down menu.

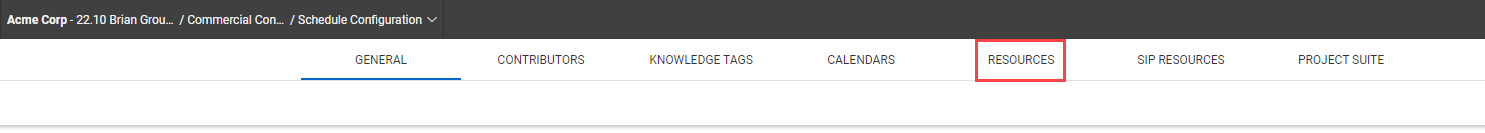

  2. Select the Resources tab in the Knowledge Base.

This brings you to the project-level resource register

The Project level resource register functions the same as the Knowledge Base. See Setting up Resources for information about how to add resources and use the Import/Export functionality in the Resources register

Schedule possesses the concept of global and project specific resources. When you create a schedule, it does not populate the resources in the Schedule Configuration window, but you can import resources from the Knowledge Base to use in your schedule.

    Project specific resources can also be added from the resource assignment window in the planning view. See the Resource Assignment for more information.

Create a project-specific resource via the Resource Assignment window

Project Specific Resources can also be created from the Resource Assignment window in the Planning view.

Step by Step — Create a Project Specific Resource via the Resource Assignment Window

  1. Without having any resources selected, click the plus icon.

    • The Add Resource opens to add a project specific resource

  2. Fill out the project resource information and then click Add.
