The Cash Flow Display Settings allow you to control what information displays on the Cash Flow graph. To open the Display Settings click on the Actions > Display Settings
icon in the Tools section.
|
Section |
Description |
|---|---|
|
1 |
You can save your display settings for future use. |
|
2 |
Select how the graph measures the timing of your cash flow. Options include: Day, Week, Month, Quarter, and Year. |
|
3 |

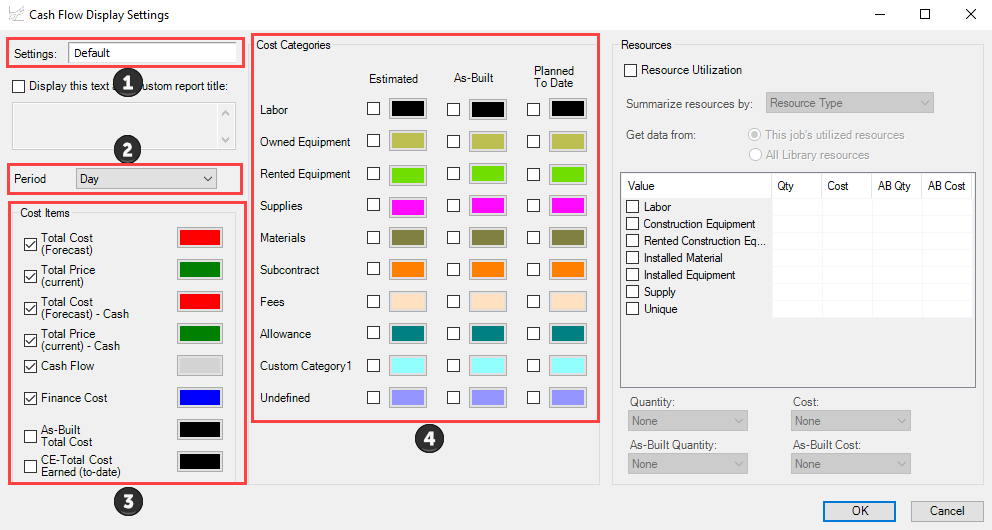

Under the Cost Items section, you can select:
|
|
4 |
You can check the Estimated box for any specific cost categories you need to display.
|
The following steps walk you through setting up your Cash Flow Display Settings.
In the E101 – Training Job, from the Estimate tab, select Cash Flow from the Schedule section.

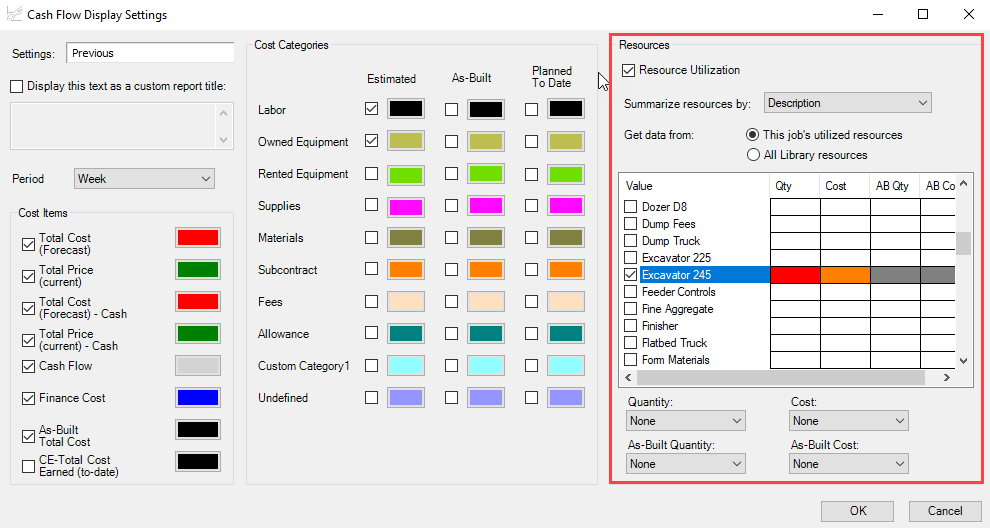

On the Actions tab, select Display Settings
to open the Display Settings window.
From the Period drop-down list, select Week.
Under the Cost Items section, make sure the following are selected:
Under the Cost Categories section, check the Estimated checkbox for the Labor and Owned Equipment categories.
Click OK to close the Display Settings window.

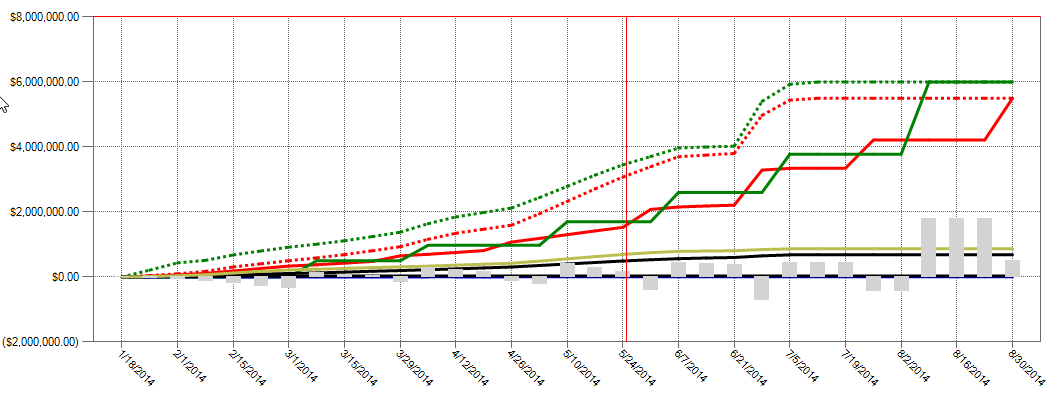

Your Total Cost (Forecast) displays as a dashed red line, indicating your accrued costs based on when your cost items are scheduled and the assigned cost curves for each cost item.
Your Total Price (current) displays as a dashed green line, indicating the revenue you’ve earned, based on the timing of your pay items
Your Total Cost (Forecast) – Cash displays as a solid red line, indicating your costs, based on when your cost items are scheduled and the cost timing defined in Cash Flow Options
Your Total Price (current) – Cash displays as a solid green line, indicating your revenue, based on the timing of your pay items and the revenue timing defined in Cash Flow Options
Your Cash Flow displays grey bars indicating when your cash flow is negative or positive
Your Finance Cost displays as a blue line on the graph

To filter your graph by date range, click on the Start drop-down arrow
and select a start date of your date range filter.
Click on the End drop-down arrow
and select an end date of your date range filter.
Your graph now only includes your cost items that fall within the specified date range
To remove the filter, click in the Start field and press the Backspace key.
Do the same for the End field.
You can also use the Cash Flow graph to report on resource utilization. For example, you may want to run a report that displays a work hours curve for a particular labor trade or to see the peak usage times for a particular piece of heavy equipment.
You can run resource utilization graphs based off of any of the following:
Resource Type
Resource Code
Description
Organizational Category
Tag 1, 2, and 3
Quote Group
Account Code and Cost Item Account Code
Fuel Type
You set up your resource utilization settings from the same Display Settings window you use for setting up Cash Flow, Display Settings
in the Tools section of the Actions menu.
The following steps walk you through setting up your Cash Flow graph to report on Resource Utilization.
In the E101 – Training Job, from the Estimate tab, select CashFlow from the Schedule section.
On the Actions tab, select Display Settings
to open the Display Settings window.
Make sure the all checkboxes are unchecked under the Cost Items and Cost Categories sections.

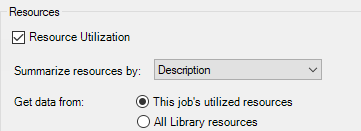

Under the Resources section, check the Resource Utilization checkbox.
From the Summarize resources by drop-down list, select Description.

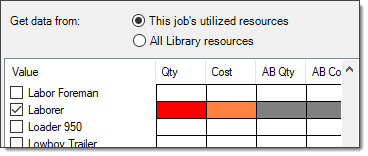

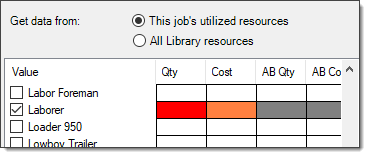

From the resulting list of Values, select Laborer.

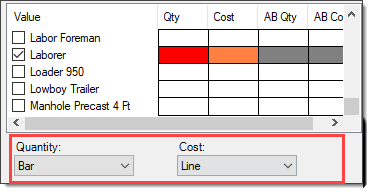

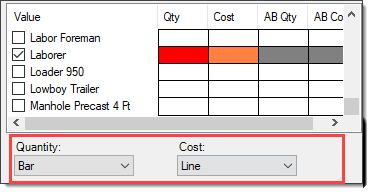

Click in the Qty field for the selected value and select a color of your choice.
In this case the Qty represents the work hours for your Laborer resource
Click in the Cost field for the selected value and select a different color of your choice.

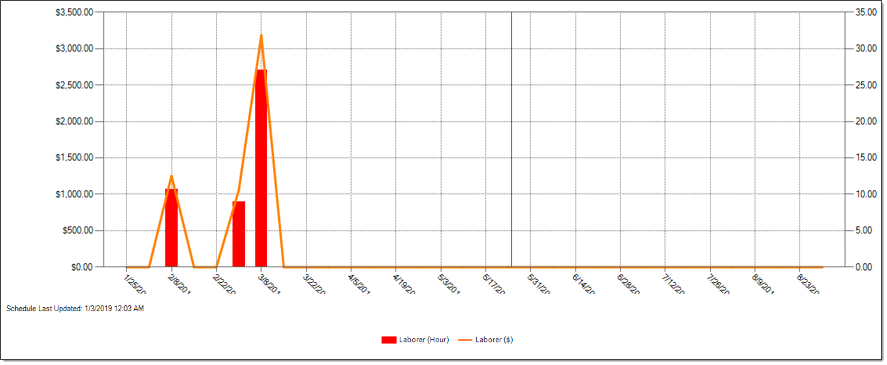

From the Quantity and Cost drop down lists, you can select how your quantities and costs will display on the graph. In this case select the Quantity to display as a Bar and Cost to display as a Line.
Click OK to close the Display Settings window.
