The project team is preparing for the execution phase of the project. With the estimate published, the project controller can now add further details to the project budget.
This section covers how to prepare the budget for project execution, including setting up pay item earning rules and locking the budget.
With your budget and pay items published from the conformed estimate, you can now set up pay item earning rules in Control.
Follow the steps below to set up earning rules for your pay items.

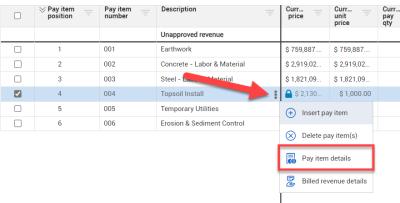

Hover over the Description and click on the three black dots.
From the menu, select Pay item details.
From the slide-out window, select the Cost Items tab.

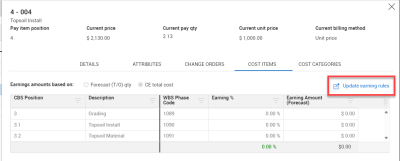

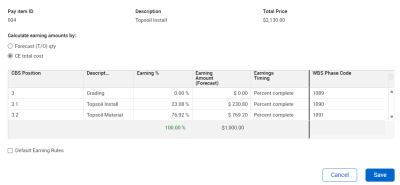

Update the earning rules details. You can make changes to the following fields:
Calculate earning amounts by (Forecast (T/O) qty, CE total cost)
Earning %
Earnings timing
When you’re finished, click Save.

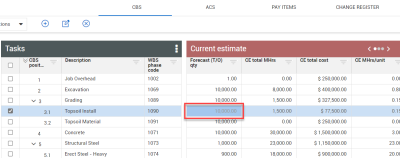

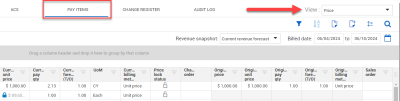

With earning rules set up, you can refer to the forecasted revenue columns for this pay item on the CBS and Pay Items tabs and check the newly populated values.
In many cases, the budget created from an estimate will need to be reorganized for field tracking purposes. Field engineers can work directly in Control to update forecast takeoff quantities with the most accurate values, while the project controller can update the CBS for project execution.
Watch the following video to learn more about reorganizing the CBS:
To update the forecast takeoff quantities, start on the CBS tab in InEight Control. Under the Forecast (T/O) qty column, double click inside a cell to make changes.
Once all configurations and updates have been completed, the budget and pay items can be locked.
Locking the budget creates an Original and Current Budget based on the Current Estimate values.
Once a budget is locked, the Original Budget cannot change. You can change the Current Budget through approved change orders.

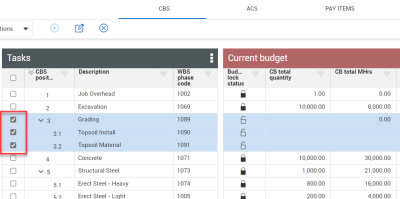

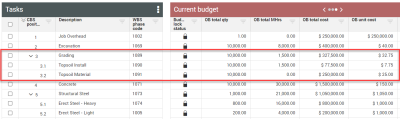

To view which cost items have been locked, add the Budget lock status column to a data block.
Follow the steps below to lock your budget:

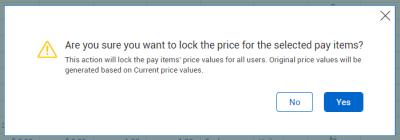

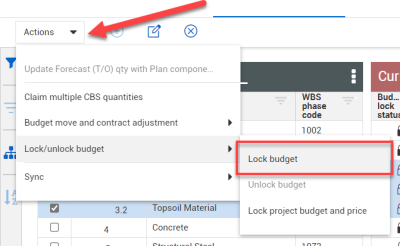

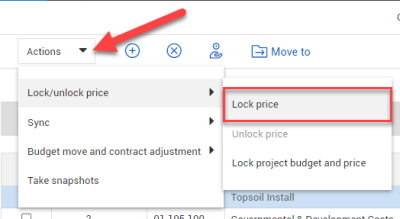

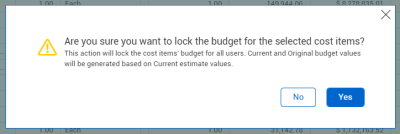

To lock the entire budget at once, open the Actions menu and select Lock/unlock budget > Lock budget and price.

Pay items can be locked following a similar process:
Additional Information
