Based on information received from the superintendent, the scheduler creates a what-if schedule to assess the potential impact on the project’s critical path, avoid additional costs from liquidated damages and account for time-dependent costs.

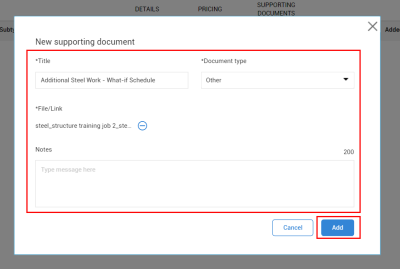

The scheduler sends a copy of the what-if schedule to the superintendent to include with the issue documentation.
Within InEight Schedule, you can create what-if schedules, adding activities and relationships as needed to determine impact on the project. A copy of the schedule can then be added to the issue’s Supporting Documents tab in InEight Change.
The following steps walk through how to create a what-if schedule for assessing issue impact.

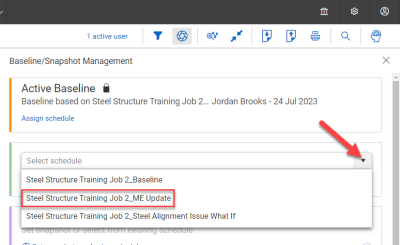

From the Home register of InEight Schedule, select your Active Update schedule (the most recent approved schedule).

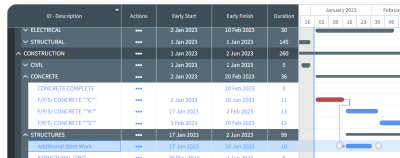

The following steps assume you need to add an activity for additional steel work under the Structures group of activities.

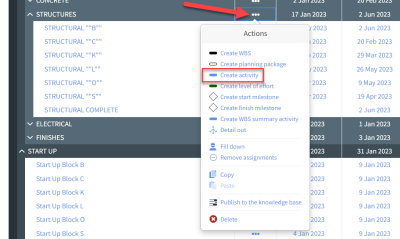

Select the Iris icon to show the side panel.

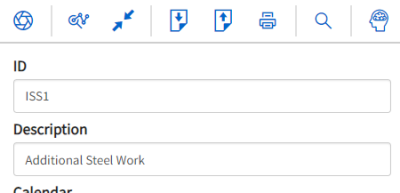

Add an ID referencing the issue ID and a description.

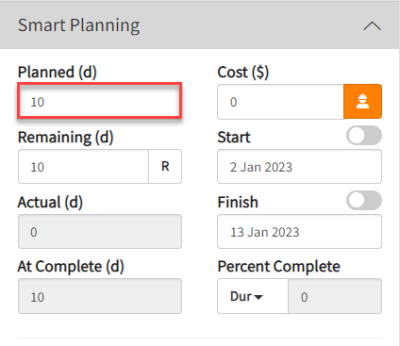

Under Smart Planning, update the duration with the estimated issue impact communicated from project team.

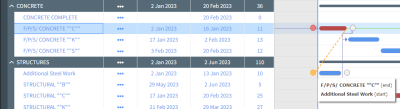

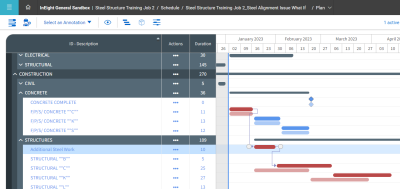

Drag to create a Finish to Start relationship between the Concrete “C” and Additional Steel Work activities.
This establishes the Concrete activity as a predecessor to Additional Steel Work. The Additional Steel Work activity moves accordingly to a later date.

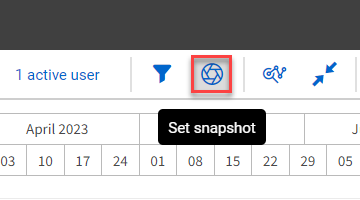

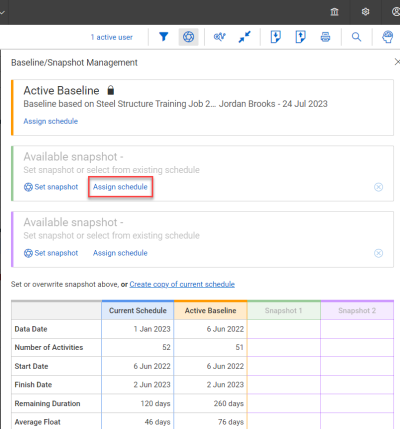

InEight Schedule includes a snapshot feature that allows you to compare your What-If schedule to a snapshot of one of your other schedules (e.g., the Active Update schedule).

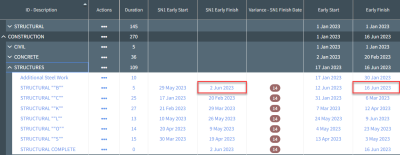

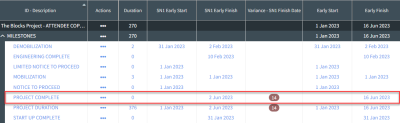

You can add variance and date columns to your view to compare the finish dates of your What-If schedule to the finish dates of your active schedule (SN1).
In this case, it delays your Structures work by 14 days.
The scheduler can print the what-if schedule as a PDF and send it back to the project team to include in the Supporting Documents of the issue.

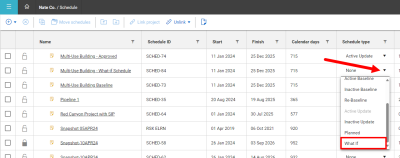

Follow these steps to link the What-If schedule in Change.

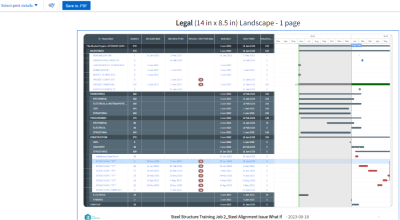

Select the Print icon to preview the schedule for printing.
Select print details to change to Legal print size and Low scale.
Select Save to PDF.
